Maw Green Road

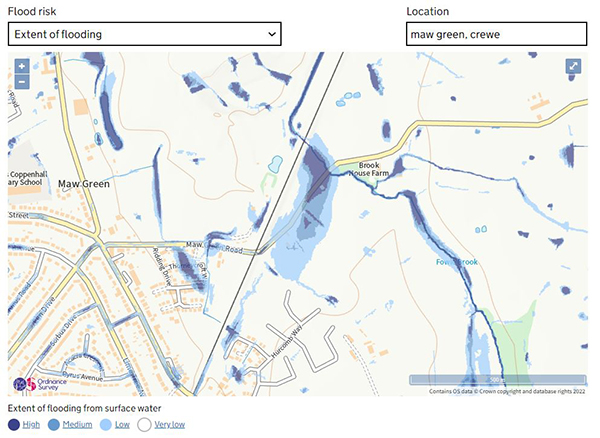

Maw Green Road passes beneath a railway line leading into Crewe and has flooded at least three times over the last five years resulting in road closures. The flooding at this location is a combination of rainfall, surface water from local drainage and ordinary watercourses and water from Fowle Brook (Main River).

Maw Green Flood Risk

What are we doing?

The Council has secured funding from the department for transport to investigate the feasibility to reduce the magnitude and frequency of the highway flooding at this location on Maw Green Road.

Stage 1

Scoping: The scoping study has been undertaken. This identifies five potential options to reduce the magnitude and frequency of flooding at this location. A full gravity solution has been discounted based on levels.

Stage 2

Feasibility: The feasibility study is now being undertaken to concluded whether a scheme to reduce the magnitude and frequency of the highway flooding at this location is feasible.

A baseline model has been constructed to calculate the volume of water draining into this area using existing data.

Further topographic survey of the highway and a cleanse and CCTV camera survey of the highway drainage and drainage connected to the landfill site  is programmed for the w/c 27 June to 1 July 2022. While the road closure is in place the highways team will also undertake local drainage maintenance and vegetation clearance.

The new data will be used to update and verify the baseline model.

The report is expected to be completed in Autumn 2022.

Stage 3

Design: If the project is viable, then option design works would commence in Winter 2022.

Stage 4

Build: Subject to landowner agreement, Environment Agency consent, planning permissions etc the very earliest date for any construction works would be Winter 2024.

Why is this such a long process?

Owing to the nature and location of the scheme there a number of key considerations, permissions an consents that need to be understood and obtained:

  • Planning Permission
  • Contaminated Land
  • Hydraulic consents (Approval needed from the EA to ensure no increased risk to property up/downstream)
  • Hydraulic Modelling needed to ensure no increase in flood risk to property up/downstream
  • Land take (volume of land required to store water prior to pumping)
  • Land Owners permission (Cheshire East Council do not own the land in question)
  • Whole life costs including maintenance regime
  • Power supply / operation
  • Construction costs (increased post covid)
  • Local infrastructure / services
