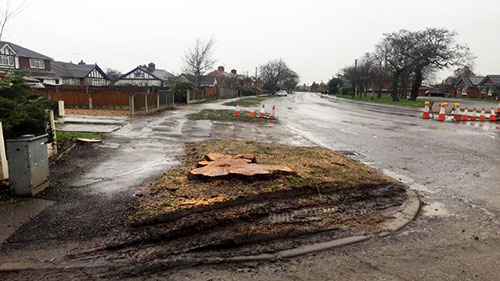

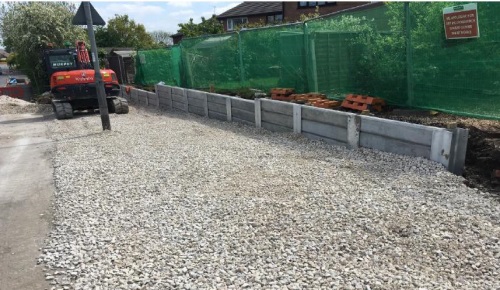

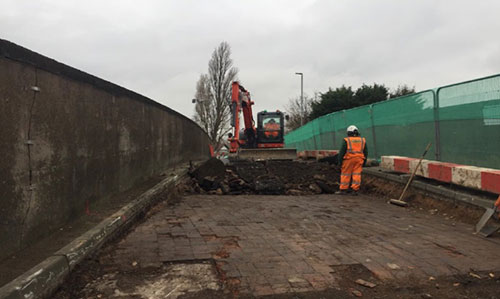

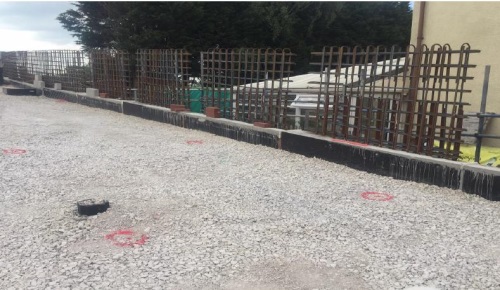

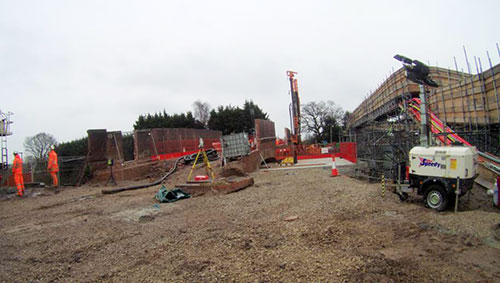

May 2018 Site compound set up on Lime Tree Avenue and relocated the ‘Police Speed Enforcement Parking Bay’ on Lime Tree Avenue. Started strengthening the embankment along side the railway track to accommodate the new bridge.

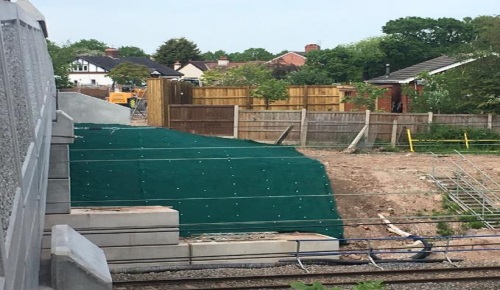

June 2018 Continued with strengthening the embankment alongside the railway track and under the bridge. Made preparations for the replacement of the Scottish Power cabling running alongside the railway tracks.

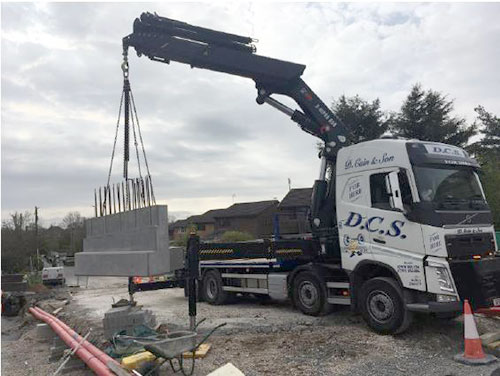

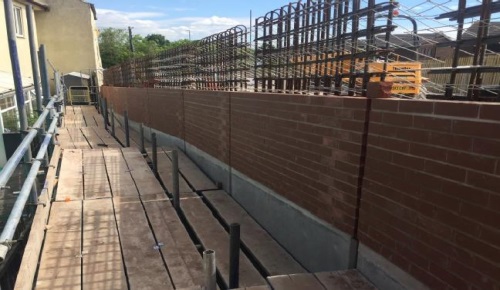

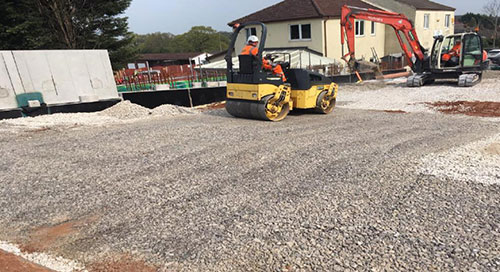

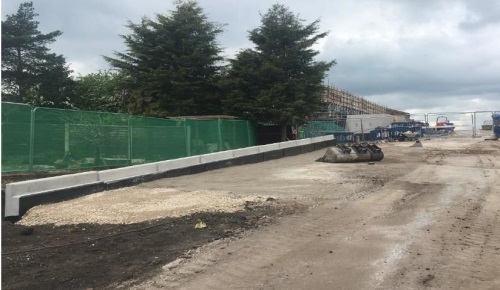

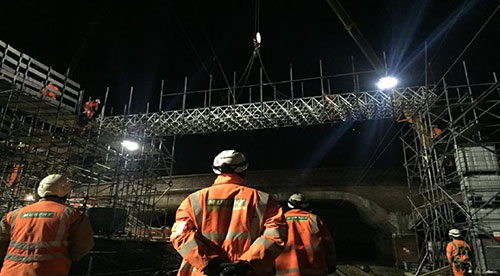

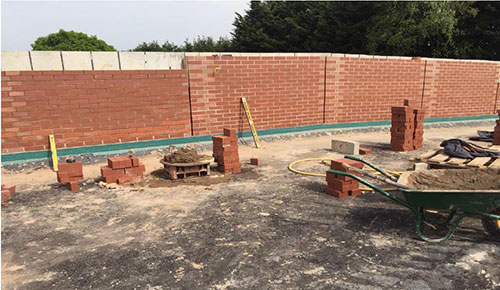

July 2018 On going strengthening work at the bridge. Installed ducting for the replacement of the Scottish Power cabling running alongside the railway tracks. Prepared and removed rail gantries, which carryover head power lines for trains.
